How Long Does a Kitchen Remodel Take in Denver? A Week-by-Week Timeline

Homeowners ask about price first and schedule second, but schedule is what you actually live with. Losing a kitchen for six weeks is manageable. Losing it for five months because nobody ordered cabinets on time is not. Here is a realistic Denver kitchen remodel timeline, including the planning work that happens before anyone swings a hammer.

The Short Answer

Cosmetic refresh: 3 to 5 weeks on site. Mid-range remodel with new cabinets and counters: 6 to 10 weeks on site. Full custom remodel with layout changes and wall removal: 10 to 16 weeks on site. Add 4 to 10 weeks before that for design, selections, permits, and cabinet lead time. Most Denver homeowners should plan on 3 to 6 months from first call to final walkthrough.

Weeks 1 to 4: Design, Selections, and Ordering

This phase decides whether the rest of the project runs smoothly. Measurements, a cabinet layout, appliance specs, and every finish selection get locked before demo. Appliances matter more than people expect: cabinet openings are built to appliance dimensions, so a late refrigerator change can force cabinet rework.

Cabinet lead time is the number one schedule driver in 2026. Stock cabinets ship in 2 to 3 weeks, semi-custom in 6 to 10 weeks, and full custom in 10 to 16 weeks. Cabinets should be ordered before demo day, not after.

Weeks 2 to 5: Permits

Permit review in the Denver metro typically takes 2 to 5 weeks depending on the jurisdiction and whether structural work is involved. Removing a load-bearing wall adds an engineer's letter and a longer review. Permit review runs in parallel with cabinet lead time, so it usually does not add to the total if the contractor files early.

Week 1 On Site: Demo and Discovery

Demo is fast, usually 2 to 4 days including protection of adjacent floors and dust containment. Discovery is what matters: this is when we find the undersized panel, the drain that was never vented correctly, or the subfloor damage under the old dishwasher. In Denver homes built before 1980, plan on at least one discovery item.

Weeks 2 to 3 On Site: Rough-In and Inspection

Framing changes, electrical rough, plumbing rough, and HVAC adjustments happen here, followed by a rough inspection. Nothing gets covered until the inspector signs off, so an inspection reschedule is a hard stop of 2 to 5 days. This is why permitted work with a contractor who knows the local inspectors moves faster, not slower.

Weeks 3 to 5 On Site: Drywall, Paint, and Flooring

Drywall patch and finish takes 4 to 6 days with proper drying time between coats. Colorado's dry climate helps here. Primer and paint follow, then flooring if it runs under the cabinets.

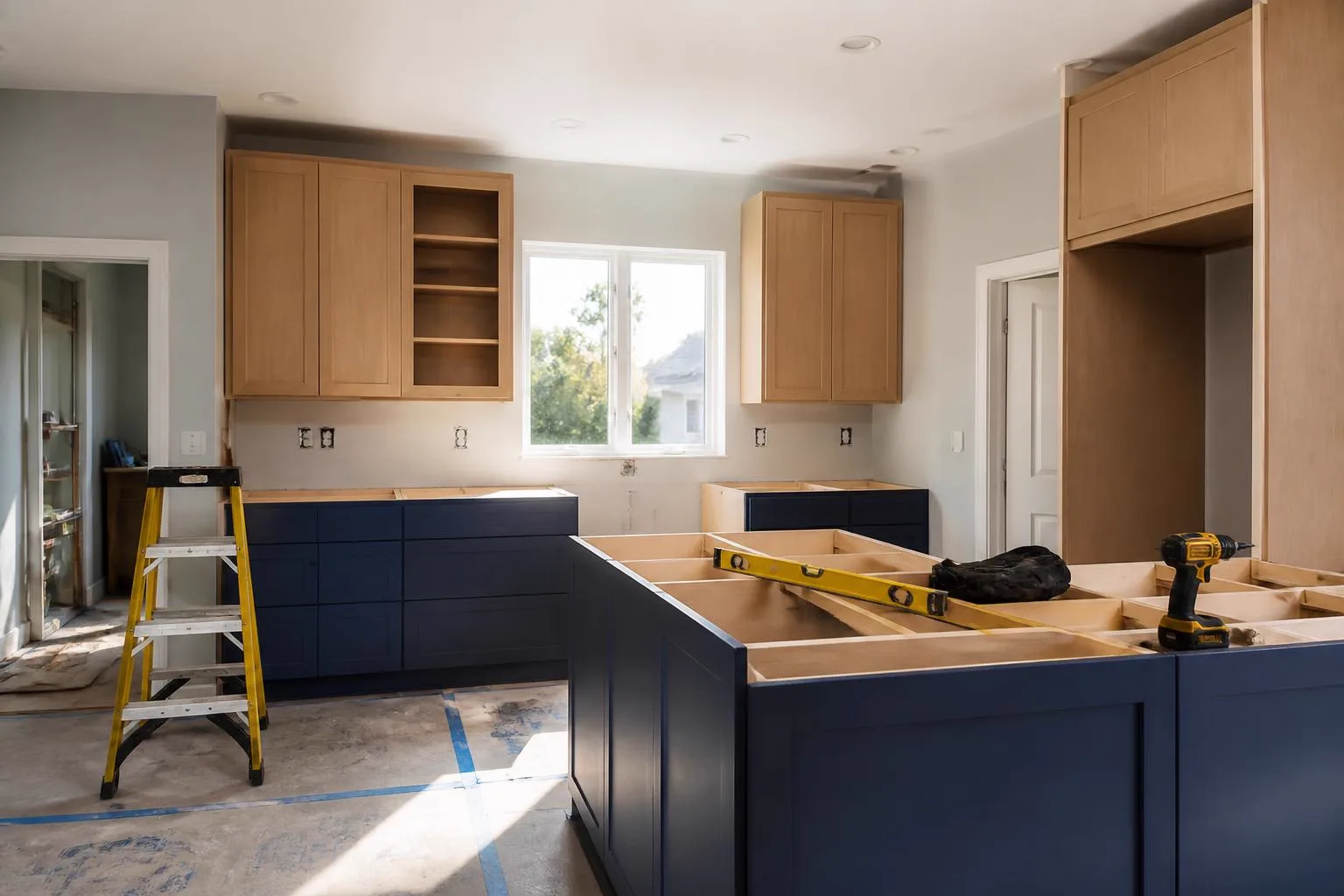

Weeks 5 to 7 On Site: Cabinets, Template, and Counters

Cabinet installation takes 3 to 5 days for a typical Denver kitchen. Counters cannot be templated until cabinets are set and level, and fabrication takes 7 to 14 days after template. That gap is the most misunderstood part of the schedule: you will have a kitchen with cabinets and no counters for about two weeks. Plan meals accordingly.

Weeks 7 to 9 On Site: Backsplash, Fixtures, and Punchlist

Once counters are in, backsplash tile, sink, faucet, appliance hookups, trim, hardware, and final electrical go in. Final inspection follows, then a punchlist walkthrough. Budget a week for punchlist items, they are small but they are what you will look at every day.

What Actually Causes Delays

Late selections. Every day a tile or faucet decision sits open is a day added at the end. Change orders mid-project. Moving a wall or adding an island after rough-in restarts inspections. Special-order appliances with 8 to 12 week lead times. Inspection scheduling around holidays. And undisclosed existing conditions in older homes, which is exactly what the contingency line is for.

How to Protect Your Schedule

Make every selection before demo. Order cabinets and appliances early and confirm ship dates in writing. Ask your contractor for a written schedule with milestone dates, and ask how many crews they run at once so you know your project will not sit idle. Set up a temporary kitchen with the fridge, microwave, and coffee maker somewhere else in the house before day one.

Planning a Kitchen in the Denver Metro?

CS Remodeling runs kitchen remodels across Denver, Commerce City, Westminster, Arvada, Thornton, Lakewood, Broomfield, Erie, and Fort Lupton with a written schedule and a single point of contact from demo to punchlist. Reach out through the contact page and we will walk your kitchen and give you both a real number and a real timeline.

Planning a project?

CS Remodeling handles basement finishing, kitchens, bathrooms, and drywall across the Denver metro area. Get a free estimate, we'll walk through your project honestly.

Contact Us
FAQ

Frequently Asked Questions

Cosmetic refresh 3 to 5 weeks on site, mid-range remodel 6 to 10 weeks, and full custom with layout changes 10 to 16 weeks. Add 4 to 10 weeks up front for design, selections, permits, and cabinet lead time.
Get In Touch

Contact CS Remodeling

We're here to help you turn your basement, bathroom, kitchen, or any part of your home into a space you'll love. Whether it's a full remodel, a simple drywall project, or just exploring ideas, our team provides clear answers, honest estimates, and expert guidance every step of the way. Reach out today, let's start planning your project the right way.
